Obsidian Impact Playbook — Issue #1] 2026 Energy Transition Capital Allocation (Private Markets): Where Returns Are and How to Underwrite Them
Energy transition investing in 2026: a private markets CIO framework covering returns, risks, grids, storage, and how to underwrite deals and impact/sustainability consideration.
I. Executive Summary
The energy transition is investable in 2026—but the highest risk-adjusted returns are shifting from “more generation” to “power system constraints”: grids, flexibility, firm clean power, and electrification infrastructure. This is where capital can be paid for solving bottlenecks rather than competing in oversupplied segments.
Key Takeaways
- 2026 alpha has moved “up the system stack.” The best risk-adjusted opportunities are no longer just building more wind/solar—they’re owning the constraints that determine whether clean generation can earn money: grids & interconnection, flexibility (storage/firming), and electrification infrastructure.
- Underwriting now hinges on three proof points—contract, grid position, security relevance. If you can’t evidence (i) bankable revenue stack (CfD/PPA/tolling/capacity), (ii) real interconnection + curtailment reality, and (iii) why the asset matters for reliability/energy security (and AI load growth), you’re not underwriting—you’re taking narrative risk.
- Allocate with a disciplined 3-stack portfolio (and avoid “tourist risk”). Use a barbell: core contracted compounding (majority of sleeve), constraint-buster value-add (grid/flex/repowering/behind-the-meter), and select strategic growth (only when the contract stack is real). Underweight pure merchant and “concept” projects where offtake, permitting, and delivery pathways aren’t already locked.
II. What’s broken (why “the transition” disappoints investors)
- Capital is ahead of grids: Global energy investment is at record levels (~$3.3T in 2025), with clean energy around $2.2T—but grid investment remains a binding constraint and needs to rise materially to keep systems reliable.
- Systems, not technologies, are the bottleneck. We can build solar and wind quickly; we struggle to connect, balance, and permit them. In the FT “The Next Five” episode, a core message is that we need materially more grid investment, and that system friction (e.g., congestion management) becomes a growing cost of high renewables penetration.
- The cost of capital (and permitting time) is now a primary climate variable: Rates, interconnection queues, and consent timelines can wipe out “cheap LCOE.”
- The transition is now energy security + industrial policy: Supply chains (transformers, cables, switchgear, inverters, critical minerals) and geopolitical alignment increasingly determine who can build on time and at cost.
- Demand is changing faster than planning cycles: Artificial intelligence compute and data centers are a step-change demand driver; credible forecasts show data center power demand rising sharply this decade.


III. Potential Investment Framework: the “3-stack allocation model”
Stack 1 — Core / Contracted cashflows (defensive compounding)
- Goal: infrastructure-like returns with strong downside protection.
- Typical assets: regulated/contracted renewables, transmission/regulated networks (where investable), contracted storage, district energy, regulated utilities/platforms.
Stack 2 — Constraint-busters / Value-add (where scarcity earns a premium)
- Goal: get paid for solving the system’s pain points.
- Typical assets: grid expansion and modernization, flexibility (storage + dispatchable clean power), interconnection-enabling assets, repowering, demand response, efficiency, behind-the-meter + C&I microgrids.
Stack 3 — Strategic growth / Optionality (higher beta, security-linked)
- Goal: selective risk for “next build cycle” winners.
- Typical assets: long-duration storage, firm clean power (incl. nuclear life extension / new build where derisked), hydrogen in narrow industrial corridors, critical minerals processing, grid software / cybersecurity.
Key CIO idea for 2026: if you can’t articulate (i) the contract, (ii) the grid position, and (iii) the security relevance, you’re not underwriting—you’re storytelling.
IV. Where are we now (facts that matter for capital allocation)

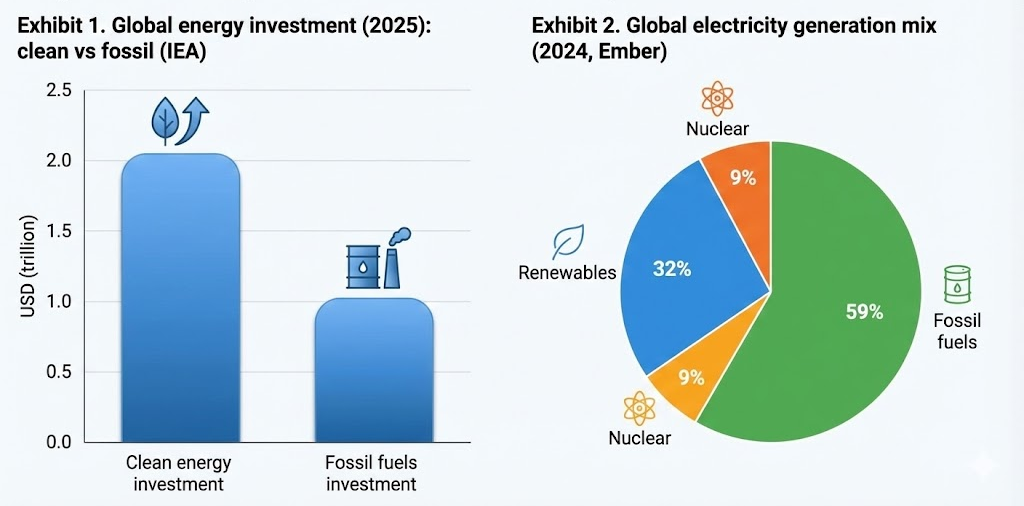

- Investment momentum is real: IEA expects record global energy investment (~$3.3T in 2025) with clean energy ~$2.2T (about twice fossil fuels).
- Electricity is central: IEA highlights electricity sector investment reaching around $1.5T in 2025, materially above upstream fossil supply spend.
- Deployment is surging: IRENA reports ~582 GW of renewable capacity additions in 2024 (record).

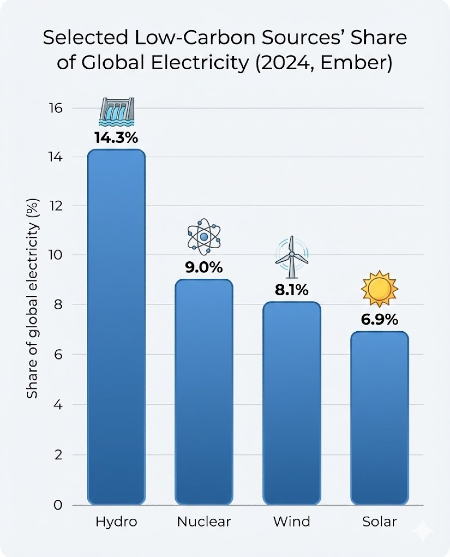

- Clean power share is rising: Ember reports clean power surpassing 40% of global electricity in 2024 (with renewables materially higher than prior years).
- Grid is the constraint (again): the FT podcast emphasizes that grid investment must rise sharply, and highlights the scale of system-management costs when infrastructure lags.
V. Potential opportunity map (2026): region × asset class
Note) Return bands below are indicative underwriting targets seen across managers and deal types—not guarantees. Where available, I anchor to disclosed manager targets.
CIO view: where to put money in 2026
If you are allocating today, yes—energy transition is investable, but don’t buy the headline. Buy the constraint.
1) Base case (“compounding + resilience”) — 50–60% of ET sleeve
- Contracted renewables with strong grid position (OECD)
- Regulated/contracted networks and enabling infrastructure
- Contracted storage (capacity/tolling/availability)
2) Constraint-buster value-add — 25–35%
- Flexibility platforms (storage + optimization + ancillary services)
- Repowering + hybridization (solar + storage; wind repower)
- Behind-the-meter/C&I power for data centers and industrials
3) Select growth / security-linked — 10–20%
- Firm clean power where derisked (life extension; structured new-build with risk sharing)
- Critical minerals processing / recycling in aligned jurisdictions
- Industrial electrification corridors benefiting from carbon policy (e.g., CBAM/ETS effects in Europe)
What I would underweight (risk/return asymmetry)
- Pure merchant renewables without a credible hedge/route-to-market.
- Mega hydrogen “concept projects” without contracted offtake and realistic power cost (unless priced as venture risk).
- Jurisdictions where offtake enforceability and repatriation cannot be solved contractually.
Potential Risks and how to mitigate them
- Grid / interconnection risk (the silent killer)
Mitigate: pay for queue certainty; require upgrade scope clarity; curtailment scenarios; nodal/basis risk modelling. - Revenue quality risk (PPA isn’t “safe” by default)
Mitigate: offtaker credit workup; termination protections; indexation; step-in rights; change-in-law clauses. - Construction + supply chain risk
Mitigate: credible EPC; liquidated damages; procurement strategy; OEM capacity and warranty diligence. - Market design / policy risk
Mitigate: prefer jurisdictions expanding long-term contracting; diversify; avoid depending on a single subsidy cliff. - Security / cyber risk (critical infrastructure)
Mitigate: cyber requirements, incident response, vendor risk; physical resilience; insurance. - Capital markets risk (rates/refi)
Mitigate: match debt tenor to contract tenor; conservative leverage; hedging policy; DSCR headroom.
VI. Implementation Strategy & Impact / Sustainability Considerations
A. Pipeline construction
- Build a funnel by Stack 1/2/3; don’t compare a contracted solar portfolio to a growth hydrogen platform on the same hurdle.
B. Underwriting requirements (minimum)
- Grid evidence pack (queue position, upgrade assumptions, curtailment history).
- Contract pack (PPA/CfD terms, credit support, remedies).
- EPC/O&M pack (fixed price scope, guarantees, delays).
- Security + resilience plan (cyber, extreme weather, physical threats).
C. Investment committee discipline
- Every deal must have:
- Base downside case (stress: price, curtailment, delays, capex +15%, rates +200 bps)
- Mitigants priced (not “hand-waved”)
- Decision rule: proceed / proceed with conditions / reprice / decline.
D. Impact / Sustainability — IC Implementation Addendum
- Treat impact as a risk-management and value-protection tool, not a parallel objective: From an IC perspective, impact discipline should reduce downside risk and protect cashflows, not sit outside underwriting.
- Require evidence that assets strengthen system resilience (grid stability, reliability, security of supply, community acceptance).
- Poor impact execution (community opposition, labor, land use, environmental non-compliance) is increasingly a direct execution and permitting risk, not a reputational afterthought.
- IC implication: impact screens belong in deal gating (permits, social license, resilience), not in post-investment reporting.
- Anchor impact claims to investment-grade evidence and avoid narrative leakage: In 2026, the primary risk is not “doing too little impact,” but over-claiming.
- Limit impact assertions to what the asset actually controls (e.g., contracted generation, grid capacity enabled, reliability services delivered).
- Avoid double counting (e.g., grid assets claiming generation impact; hydrogen projects claiming decarbonization without offtake).
- IC implication: require a short impact evidence memo alongside the investment memo, aligned to recognized norms (e.g., GIIN/Impact Frontiers logic), but scoped to what affects underwriting credibility.
- Align impact objectives with capital structure, incentives, and exit—not storytelling: Impact only matters to ICs if it is embedded in contracts, covenants, or value creation plans.
- Use impact-linked mechanisms selectively (e.g., availability, reliability, or emissions-intensity metrics that affect pricing or step-ups).
- Ensure impact positioning is exit-ready—i.e., credible to the next buyer or lender and defensible under regulatory scrutiny.
- IC implication: if impact cannot be translated into better financing terms, lower risk, or broader buyer pools, it should not complicate the deal.
VII. Appendix
A) Opportunity map — by asset class (global, private-weighted)
“Where should I put money in 2026?”
If you can only do a handful of things (private assets, CIO lens), the 2026 “highest Sharpe” playbook is:
- Overweight grids + interconnection + critical equipment (regulated where possible; quasi-regulated where not). This is the universal bottleneck across regions.
- Core contracted renewables (operating) + repowering + hybridization (upgrade cashflows rather than underwriting heroic greenfield).
- Contracted flexibility (BESS tolling / capacity-backed) where market design pays for reliability (avoid pure merchant unless you are a specialist).
- Select offshore wind only if repriced and derisked (secondaries, contracted, strong EPC discipline).
- Behind-the-meter + electrification infrastructure for critical loads (data centers / industrials), with tight contracts and performance guarantees.
- EM selectively (India, Brazil, parts of Africa) only with de-risking wrappers (sovereign/central offtake, MDB guarantees, hard-currency structures).
- Hydrogen/SAF/CCUS only when the contract stack is real (bankable offtake + subsidy clarity + infrastructure pathway) — otherwise treat as venture-risk.
VIII. Sources
- Financial Times — The Next Five, Episode 39: “Leading the Energy Transition: Where Are We Now?” (Podcast page / transcript) — n.d. — Global overview + key constraints — https://thenextfive.ft.com/39-leading-the-energy-transition-where-are-we-now
B) Full bibliography
B1) Global investment / deployment / system mix
- IEA — World Energy Investment 2025 (Report PDF) — June 2025 — Global energy capex baseline; clean vs fossil split — https://iea.blob.core.windows.net/assets/1c136349-1c31-4201-9ed7-1a7d532e4306/WorldEnergyInvestment2025.pdf
- IEA — World Energy Investment 2025: Executive Summary (Webpage) — 2025 — Headline numbers and framing — https://www.iea.org/reports/world-energy-investment-2025/executive-summary
- Ember — Global Electricity Review 2025 (Report PDF) — April 8, 2025 — Global generation mix + clean power share — https://ember-energy.org/app/uploads/2025/04/Report-Global-Electricity-Review-2025.pdf
- IRENA — Renewable Capacity Statistics 2025 (Report page) — March 26, 2025 — Renewable capacity additions in 2024 — https://www.irena.org/Publications/2025/Mar/Renewable-Capacity-Statistics-2025
- IRENA — Renewable Power Generation Costs in 2024 (Report PDF) — 2025 — Cost curves and competitiveness — https://www.irena.org/-/media/Files/IRENA/Agency/Publication/2025/Jul/IRENA_TEC_RPGC_in_2024_2025.pdf
B2) Grid/interconnection / market design
- FERC — Order No. 2023 (Final rule page) — 2023 — Interconnection process reforms — https://www.ferc.gov/media/order-no-2023
- European Commission — Electricity market design reform (Policy page) — 2024 — Long-term contracting / market reform — https://commission.europa.eu/energy-climate-change-environment/energy-policy/electricity-market-design_en
B3) Demand shock (AI, data centers)
- S&P Global Commodity Insights — Global data center power demand expected to almost double by 2030 (Analysis) — November 5, 2025 — Quantified load growth driver — https://www.spglobal.com/energy/en/news-research/latest-news/electric-power/110525-global-data-center-power-demand-expected-to-almost-double-by-2030
- IEA — Energy and AI (Report page) — April 10, 2025 — Scenarios and demand modelling for AI and data centers — https://www.iea.org/reports/energy-and-ai
B4) UK contracting
- UK DESNZ — CfD Allocation Round 6 results (Official results page) — 2024 — Auction cleared capacity / strike prices — https://www.gov.uk/government/publications/contracts-for-difference-cfd-allocation-round-6-results
B5) Trade/industry policy
- European Commission — CBAM (Policy page) — ongoing — CBAM timing and scope context — https://taxation-customs.ec.europa.eu/carbon-border-adjustment-mechanism_en
B6) Manager disclosure (return anchoring)
- Copenhagen Infrastructure Partners — Annual Report 2023 (Annual report PDF) — 2023 — Illustrative manager return targets — https://www.cip.com/media/1itpsldf/cip-annual-report-2023.pdf
C) Primary legal texts
- EUR-Lex — Directive (EU) 2024/1711 (Directive) — 2024 — EU electricity market design reform — https://eur-lex.europa.eu/eli/dir/2024/1711/oj
- EUR-Lex — Regulation (EU) 2024/1747 (Regulation) — 2024 — EU electricity market design reform — https://eur-lex.europa.eu/eli/reg/2024/1747/oj
- EUR-Lex — Regulation (EU) 2023/956 (CBAM) (Regulation) — 2023 — CBAM legal text — https://eur-lex.europa.eu/eli/reg/2023/956/oj
- IEA — World Energy Investment 2025 (Report PDF) — June 2025 — Global capex levels; clean vs fossil; power investment — https://iea.blob.core.windows.net/assets/1c136349-1c31-4201-9ed7-1a7d532e4306/WorldEnergyInvestment2025.pdf
- IEA — World Energy Investment 2025: Executive Summary (Webpage) — 2025 — Key headline figures — https://www.iea.org/reports/world-energy-investment-2025/executive-summary
- Ember — Global Electricity Review 2025 (Report PDF) — April 8, 2025 — Clean power share; generation mix trends — https://ember-energy.org/app/uploads/2025/04/Report-Global-Electricity-Review-2025.pdf
- IRENA — Renewable Capacity Statistics 2025 (Report) — March 26, 2025 — 2024 renewable capacity additions — https://www.irena.org/Publications/2025/Mar/Renewable-Capacity-Statistics-2025
- IRENA — Renewable Power Generation Costs in 2024 (Report PDF) — 2025 — Cost trends; competitiveness — https://www.irena.org/-/media/Files/IRENA/Agency/Publication/2025/Jul/IRENA_TEC_RPGC_in_2024_2025.pdf
- European Commission — Electricity market design reform (Policy page) — 2024 — EU long-term contracting / market reform — https://commission.europa.eu/energy-climate-change-environment/energy-policy/electricity-market-design_en
- European Commission — Carbon Border Adjustment Mechanism (CBAM) (Policy page) — ongoing — CBAM context for industrial decarb — https://taxation-customs.ec.europa.eu/carbon-border-adjustment-mechanism_en
- S&P Global Commodity Insights — Global data center power demand expected to almost double by 2030 (Analysis) — November 5, 2025 — AI/data-center demand driver — https://www.spglobal.com/energy/en/news-research/latest-news/electric-power/110525-global-data-center-power-demand-expected-to-almost-double-by-2030
- UK DESNZ — Contracts for Difference (CfD) Allocation Round 6 results (Official results page) — 2024 — UK auction outcomes / contracting architecture — https://www.gov.uk/government/publications/contracts-for-difference-cfd-allocation-round-6-results
- FERC — Order No. 2023: Generator Interconnection Reforms (Final rule page) — 2023 — US queue reform direction — https://www.ferc.gov/media/order-no-2023
- Copenhagen Infrastructure Partners — Annual Report 2023 (Annual report PDF) — 2023 — Manager-stated return targets (illustrative only) — https://www.cip.com/media/1itpsldf/cip-annual-report-2023.pdf
Note) 'Sources' were put together with the help of AI.
